This website uses cookies and other tracking technologies to enhance navigation, facilitate feedback, analyze usage of our products and services, support marketing efforts, and deliver third-party content. View our Privacy Policy.
Innovative Battery Manufacturing Facilities Construction management consultancy for building innovative battery manufacturing facilities in the United States. Bechtel is at the forefront of constructing innovative battery manufacturing facilities in the U.S. Our expert team ensures compliance with local codes and…
The Bechtel-built mine, one of the largest copper resources, features a first-of-its-kind desalination plant and will operate on 100% renewable energy by 2025.
Bechtel is delivering one of Australia’s largest infrastructure projects — a state-of-the-art airport designed to handle 10 million passengers annually.
Fostering Economic Growth Through Easier and More Accessible Transportation
In the globalized economy, continued growth requires easy and accessible movement within and across borders. Better transportation enables stronger relationships between communities, big and small, increasing opportunities for trade, jobs, and further investments.
To boost economic development and create stronger ties to the surrounding region, the Serbian government is transforming its transportation infrastructure with the Morava Motorway. The motorway will improve connectivity, efficiency, and traffic flows in established central Serbian and Pan-European corridors, and it will include an expansive telecommunication network to support local communities.
About the Project

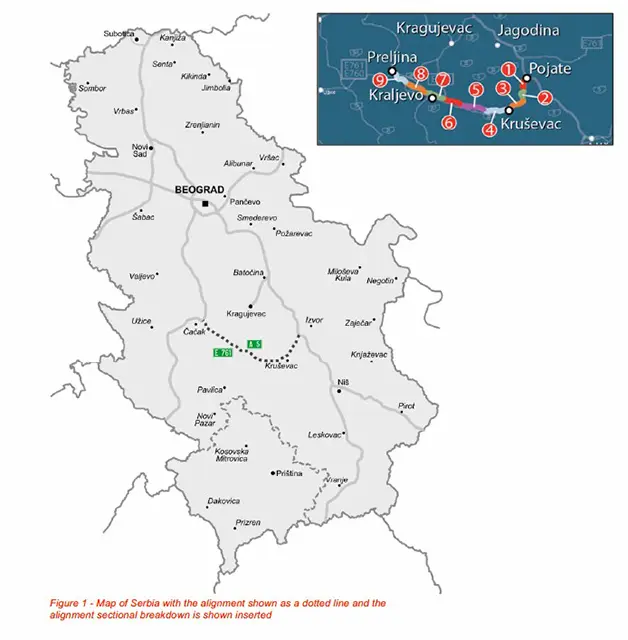

Totaling 112 kilometers, the dual-carriageway tolled motorway will be the country’s second major transport artery. It will connect east to west, from Pojate to Preljina, and link the North-South motorway between Serbia’s border with Hungary and North Macedonia. The corridor will fit into a larger transportation network spread throughout the Balkans as part of a regional plan to improve trade links and build ties to Western Europe.
The government plans to create three industrial zones along the corridor, supported by the telecommunication network, which will help the economic development of the local municipalities.
Construction began in 2020, and Bechtel, in a joint venture with ENKA, Turkey’s largest construction company, expects the first two sections to be completed during 2023.
Building Trade Links
The motorway is of critical importance to the economic development of the Morava River Valley and Serbia’s transport infrastructure, the Serbian government said.
By linking to Corridors X and XI, which run north and south to Austria and Greece, the Morava Motorway will expand access to markets in Slovenia, Croatia, North Macedonia, Italy, and Romania. Additionally, the motorway will connect with commercial centers such as Sarajevo, the capital of Bosnia and Herzegovina, and Bar, a port city in Montenegro.
Connections created by the project go beyond Eastern Europe. In October 2021, the project received a €430 million guaranteed loan by U.K. Export Finance as part of an exporter agreement. It is the first export credit deal concluded by Serbia’s Ministry of Finance and BEJV. The agreement will create a value of €150 million for the U.K. economy.
Digital Corridor
Beyond the economic benefits, the motorway will have the potential for 1,000 kilometers of fiber optic cable being laid to create a digital corridor. The network will be built using power lines, communication cables, and substations and will include mobile phone base stations at rest areas and near traffic loops to help manage traffic controls.
Not only will the digital corridor provide a fast and reliable exchange of information, but it will enable safe traffic and comfortable use of the motorway and allow for highspeed broadband internet to be fed into the economic development zones.
When designing the digital corridor, the engineering team planned for the next 100 years, incorporating current-day technology along with the flexibility to handle the technology of tomorrow.
Flood Solutions
Since the motorway is being built along the Morava River’s flood plain, innovative engineering solutions will be used to address flooding concerns and cope with 100-year flood events. The flood mitigation system is the first of its kind in scale to be built alongside a motorway in the Balkans, and it involves channeling and straightening the river along a 40-kilometer stretch to protect the road and the surrounding area without impacting towns or increasing flooding elsewhere.
Construction will include a variety of extra flood protection measures, such as long river diversions, dikes, and the construction of new riverbeds due to the wide flood plain of the river. Excavated material from the river diversion will be used to build the embankments and to build the motorway above ground level. Additionally, Bechtel and ENKA will build a flood defense system to protect areas around the motorway from flooding, erosion, and water pollution, reflecting the government’s commitment to strengthen national infrastructure and create resilience against extreme weather conditions.
Working with the Community
Aiming to leave a positive legacy, the project partnered with the University of Belgrade’s Faculty of Civil Engineering to lead an internship program. Six civil engineering students are part of the BEJV team, contributing to the success and progress of the Morava Motorway. The project also emphasized hiring locally. Out of a total of 2,667 workers onsite, 47%, or 1,663, are local. All of this was made possible through the regular and constant engagement of the BEJV team with local stakeholders and local key partners alongside the Motorway alignment.
Additionally, to maintain minimal impact on the environment, specialists on the project, with the help of the Serbian Institute for Nature Conservation, conduct pre-construction surveys to decide on site-specific protection strategies for sensitive fauna. Actions include, identification, protection, and if necessary, relocation of wildlife.
Fast Facts
The project includes 88 bridges, and the total number of underpasses and overpasses will be 15 and 27, respectively.
While excavation will total approximately 48 million cubic meters, the earth fill will be 22 million cubic meters.
The amount of concrete used will be 1 million cubic meters, subbase will be 1.8 million cubic meters, asphalt 1.2 million tons, and guardrails will extend to a total of 475 kilometers.
Over 1,000 kilometers of optic fiber will be involved for the 5G infrastructure.
Construction began in 2020, and the first bridge was completed in 2021.
Related Resources
Kosovo
Kosovo Motorway
2019
Bechtel completed Kosovo’s award-winning motorways, Routes 6 & 7, prioritizing safety and sustainability while enhancing regional connectivity and economic growth.
Bechtel Marks Major Progress on Serbia’s Morava Motorway
Project moves beyond 50% complete Bechtel and joint venture partner ENKA today celebrated the opening of an additional 30 km of the Morava Corridor Motorway, which connects the cities of Kruševac and Vrnjačka Banja. The Morava Corridor Motorway, a 112-km...
Bechtel-ENKA Recognized with Distinguished International Project Management Award
The Bechtel-ENKA Morava Corridor Motorway team has been honored with the International Road Federation’s (IRF) Global Program Management Award. This recognition recognizes outstanding leadership and excellence in the management and delivery of road infrastructure programs that enhance mobility, safety, and...
Bechtel-ENKA Receives Prestigious International Environmental Award
112-km Morava Motorway Project in Serbia Honored for Conservation Efforts The International Road Federation (IRF) has recognized the Bechtel-ENKA Joint Venture with the Global Road Achievement Award for its environmental stewardship on the Morava Corridor Motorway project located in Serbia....
Momentum on the Morava: How In-House Solutions At-Scale Are Driving Project Success
By: Chris Jennions
The road to success, it is often said, is always under construction—and nowhere is that truer than the Morava Corridor project in Serbia. Since breaking ground just five years ago, the Bechtel-ENKA joint venture team has made substantial progress. Yesterday,...
